Big Door Prize — Quepos
Line extension · Easement · National road

Big Door Prize — Quepos

2,242 mPVC pipeline 100/150 mm
₡85.8MCFIA valuation
100%received by AyA
Documented case · Quepos, Puntarenas

Big Door Prize: the pipeline that crossed a national road

2,242 meters of pipe, an easement over third-party land, a national road crossing, and even a constitutional injunction. RAM's flagship project, told phase by phase.

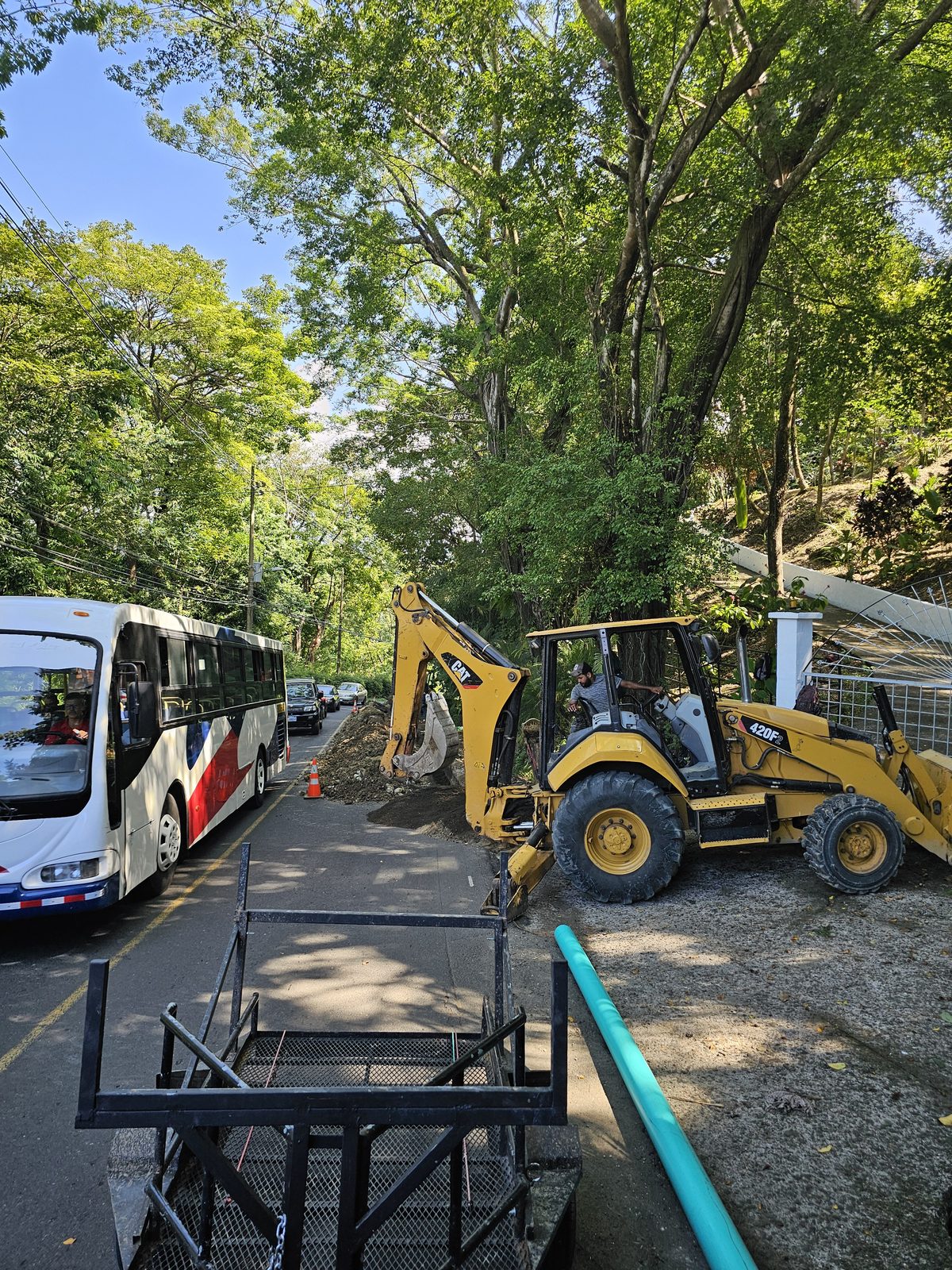

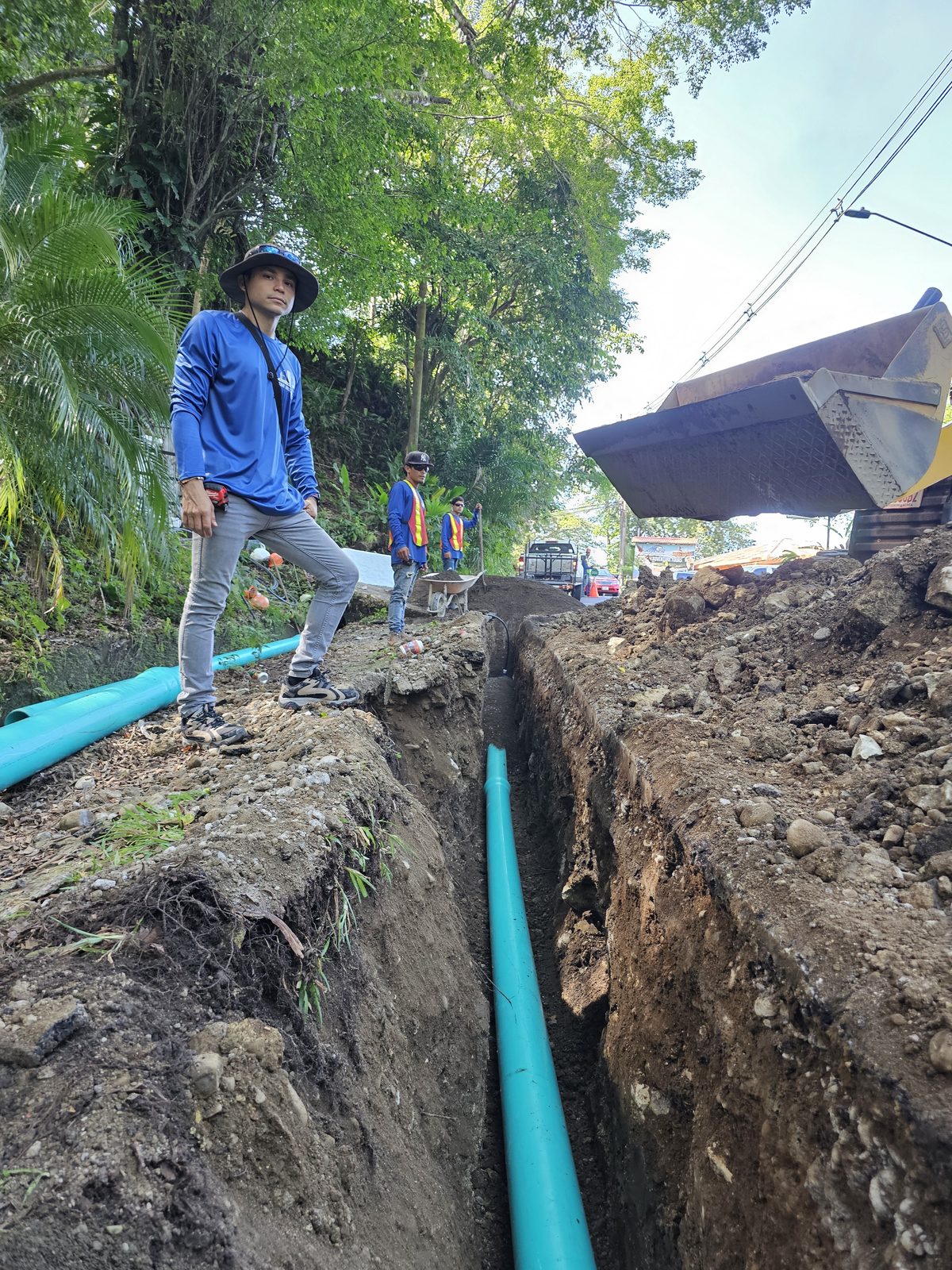

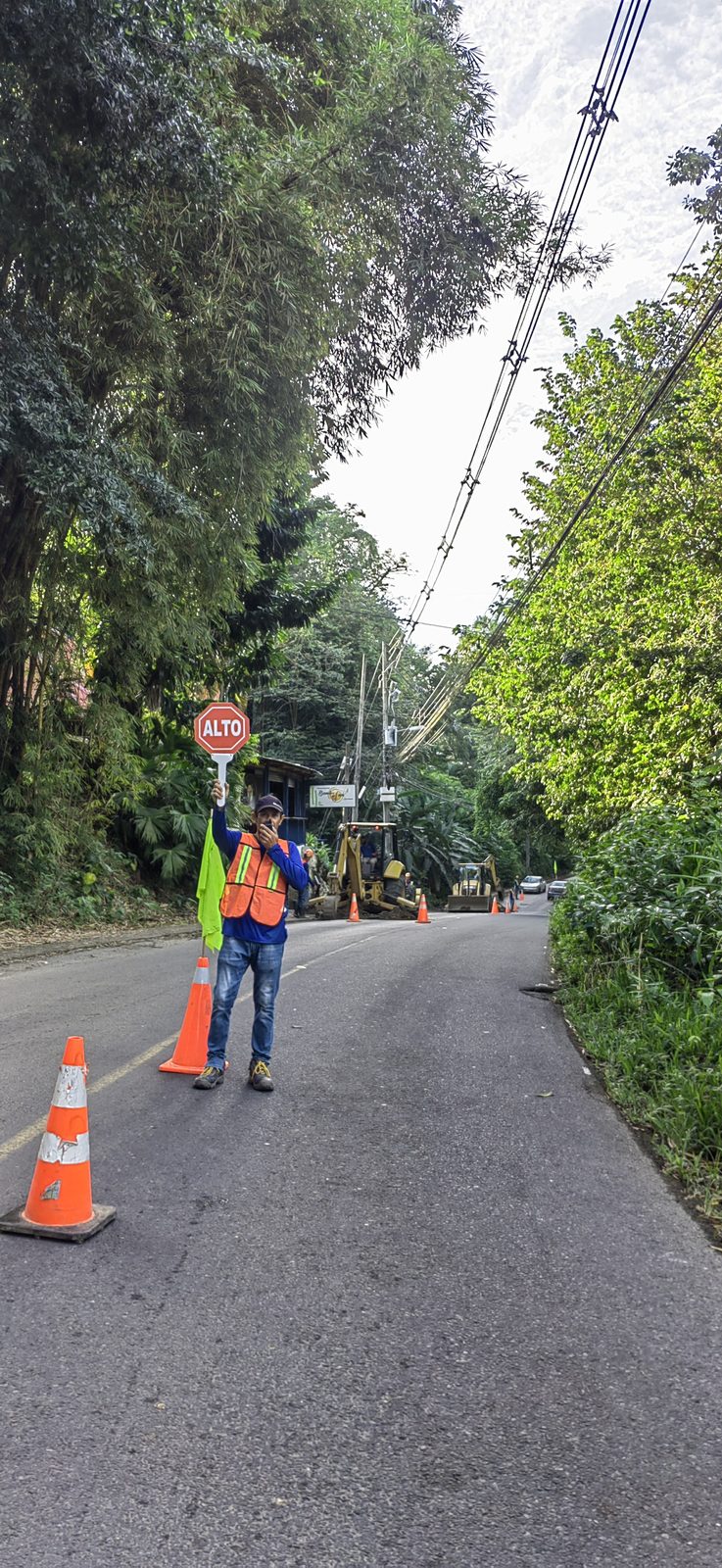

Start of the Big Door Prize pipeline works in Quepos
01
The starting point

A tourism project without formal water

The Manuel Antonio development needed a water availability letter to be viable, and AyA conditioned it on building distribution infrastructure that didn't exist: a pipeline that also had to cross a national road and third-party land.

Three institutional obstacles in one project: design to AyA standards, road-cut permits from MOPT and CONAVI, and an easement to be constituted. Any of the three, mishandled, killed the project.

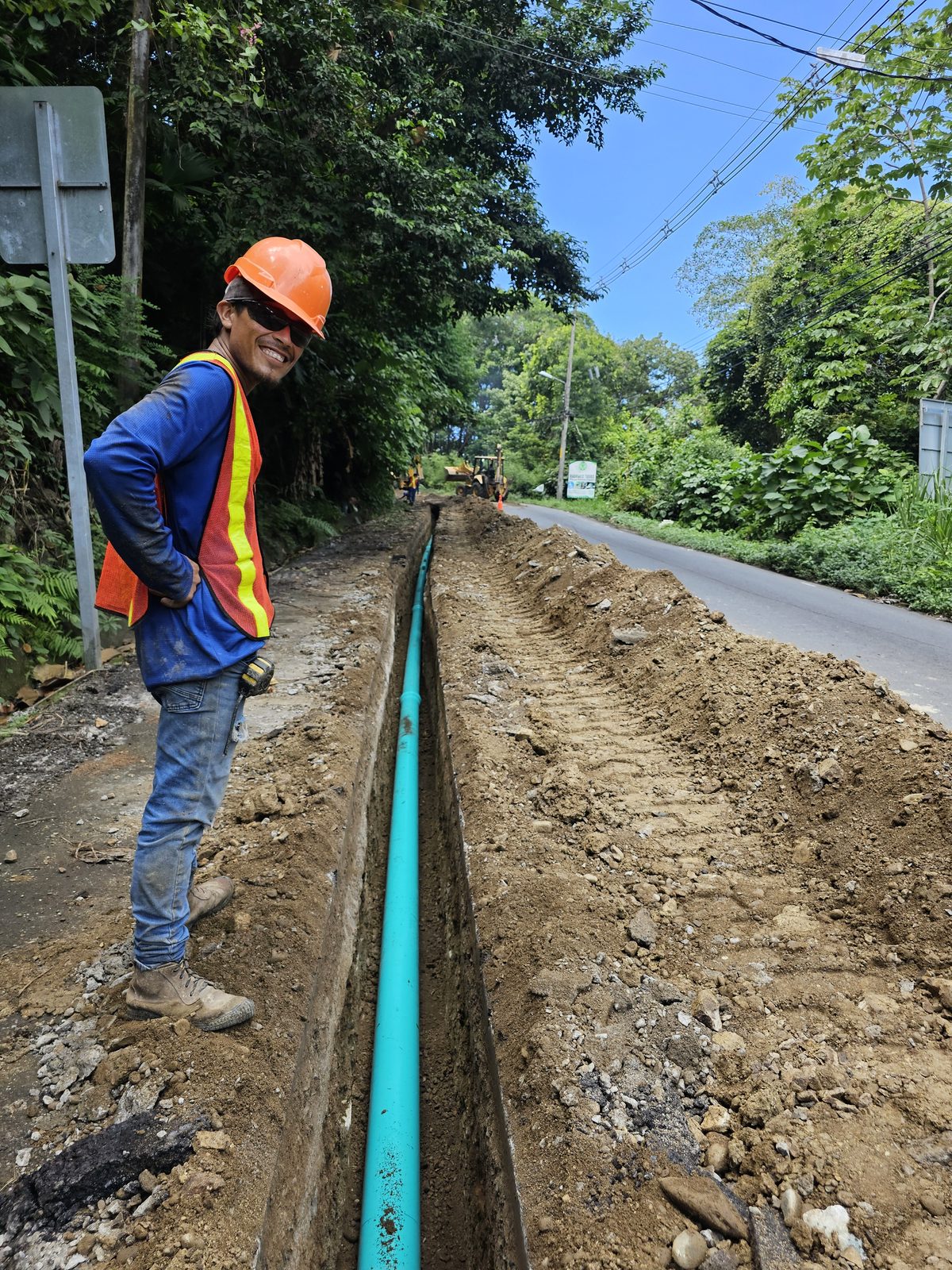

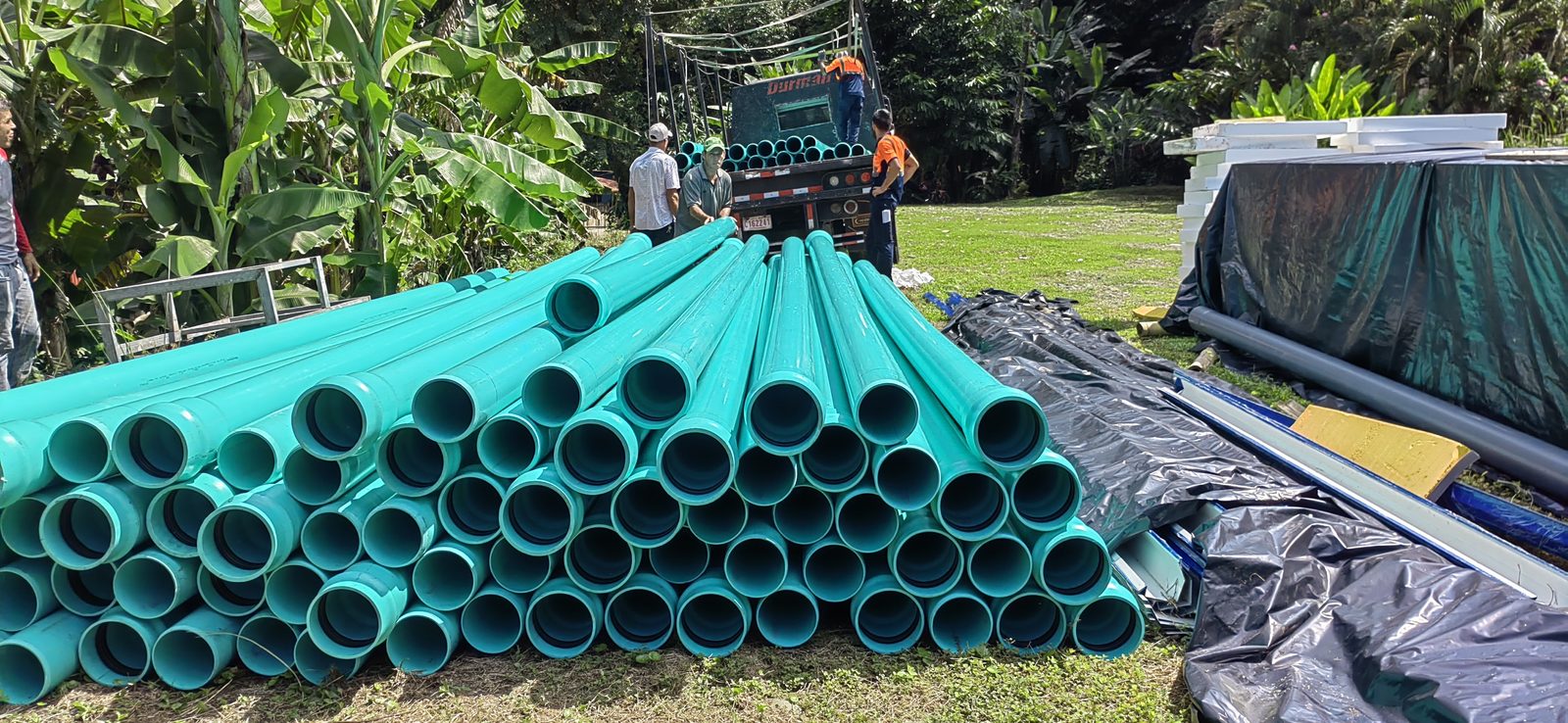

2,242 mof 100/150 mm PVC pipe to build

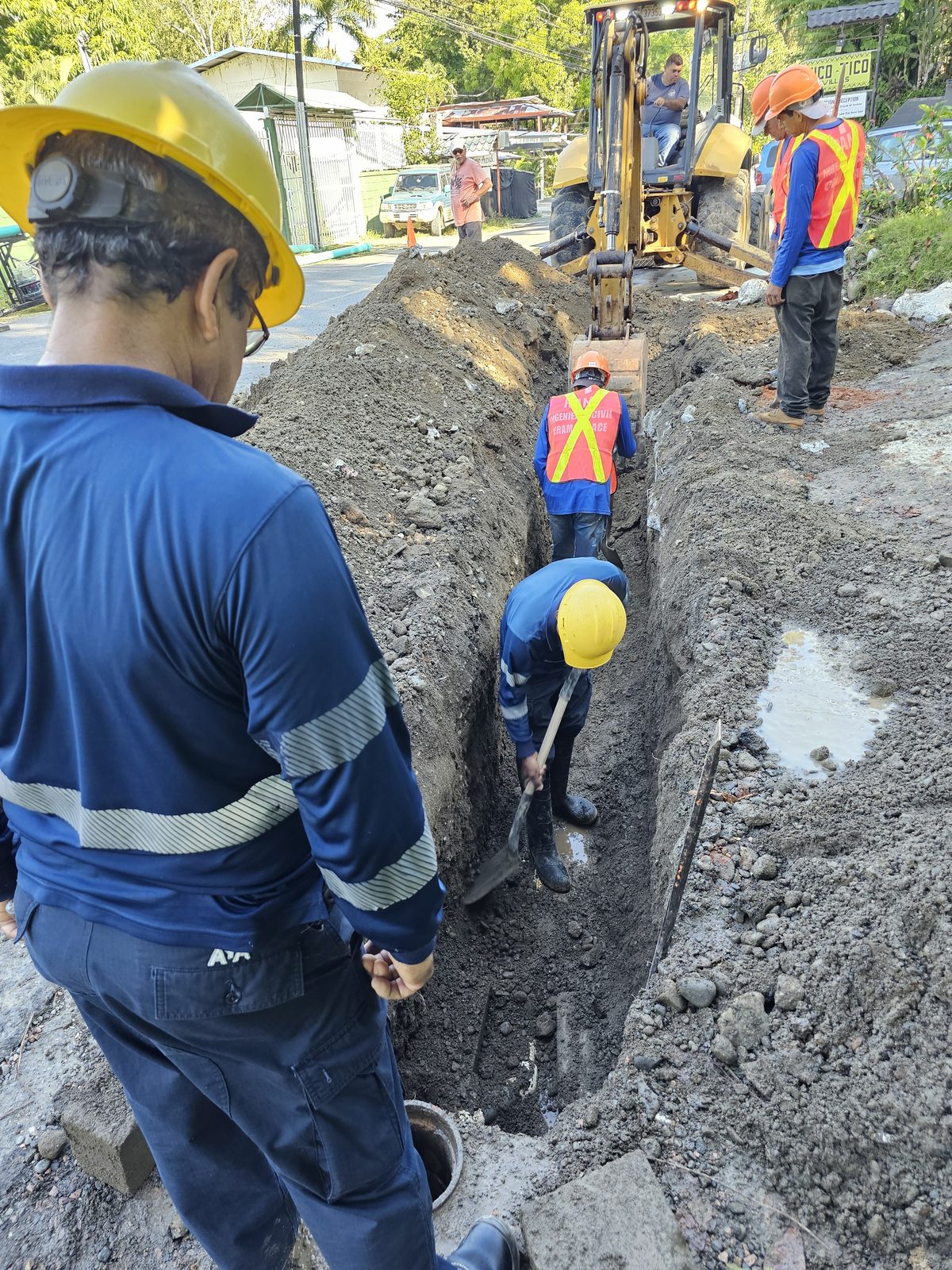

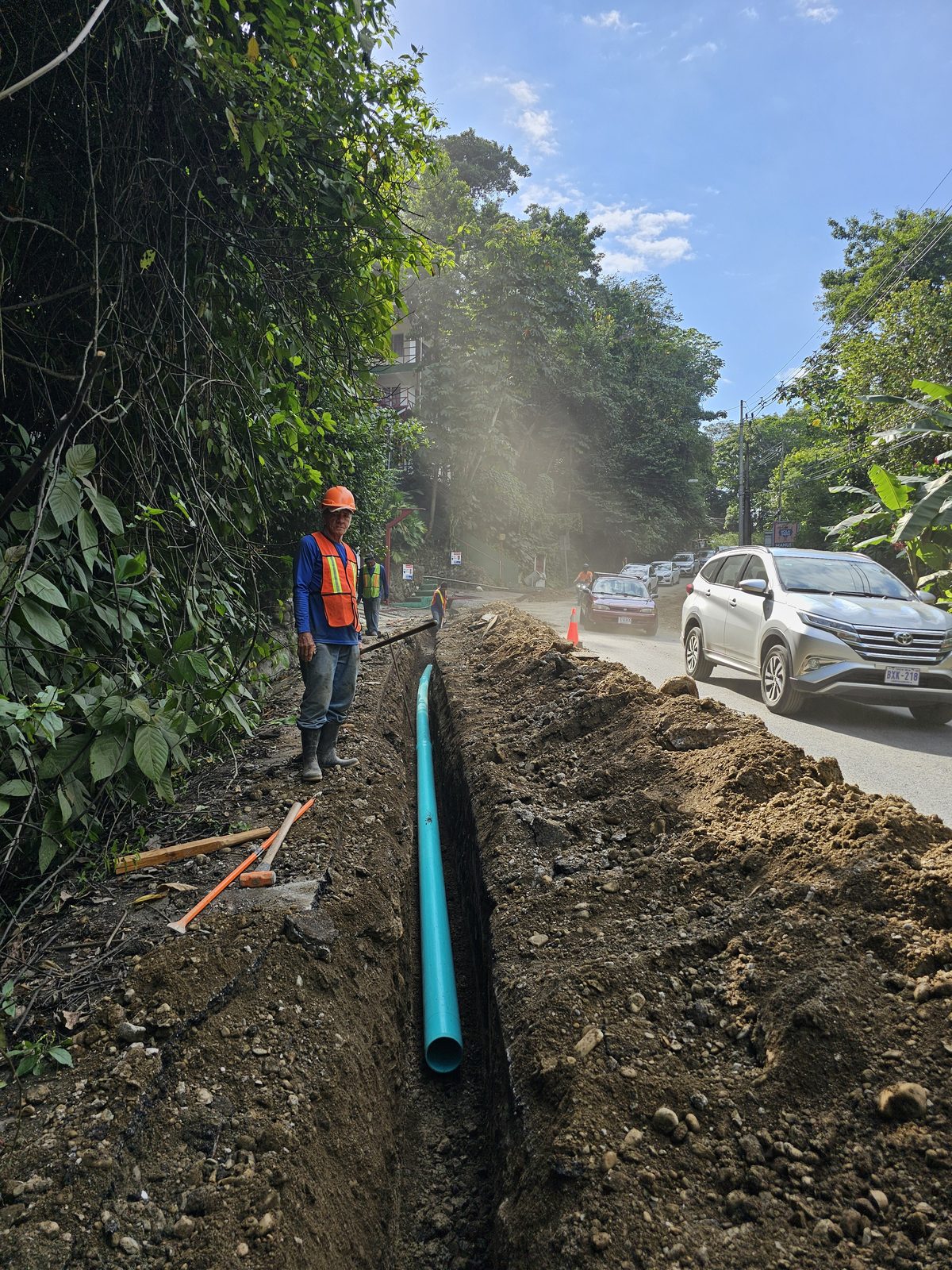

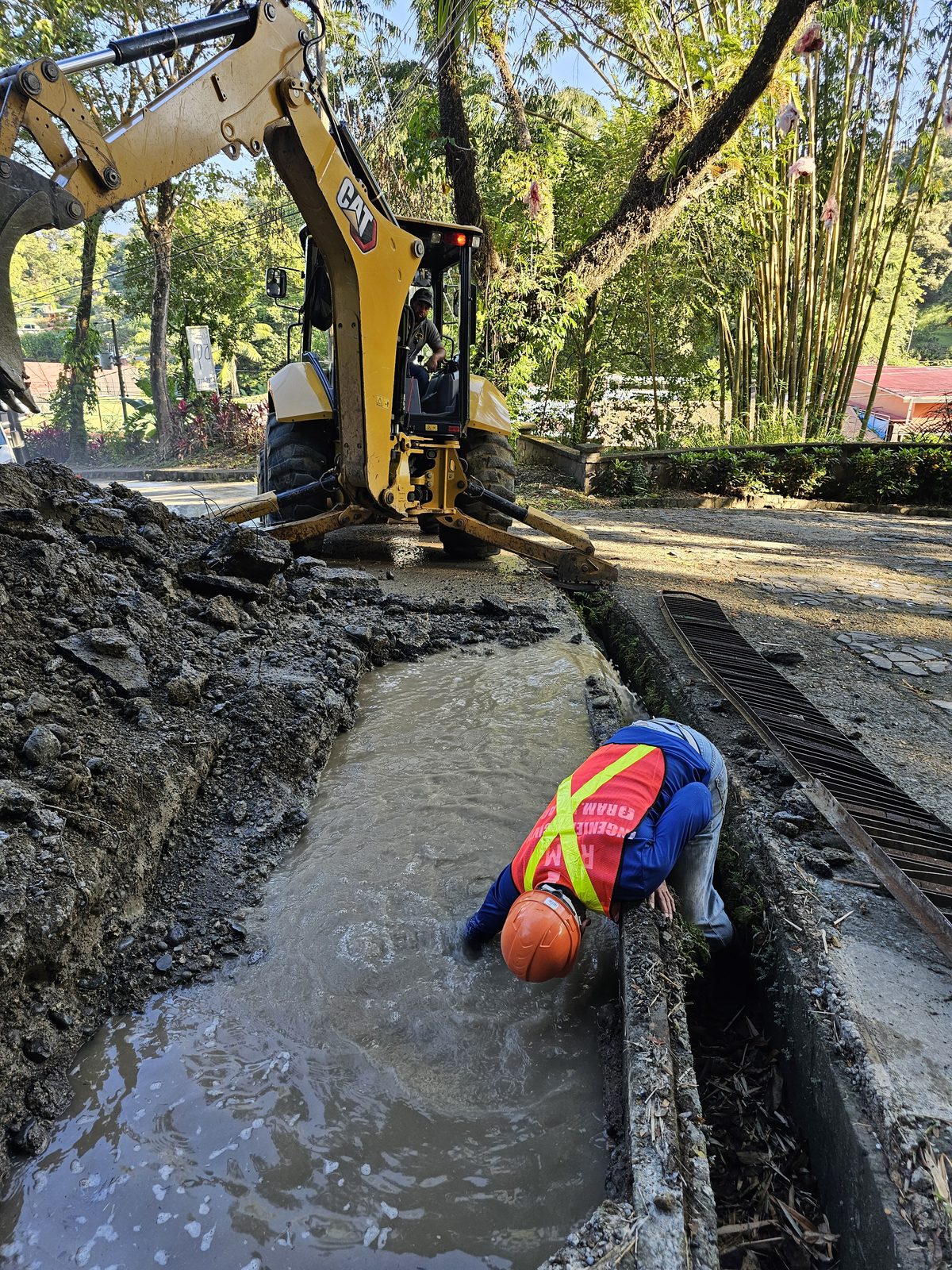

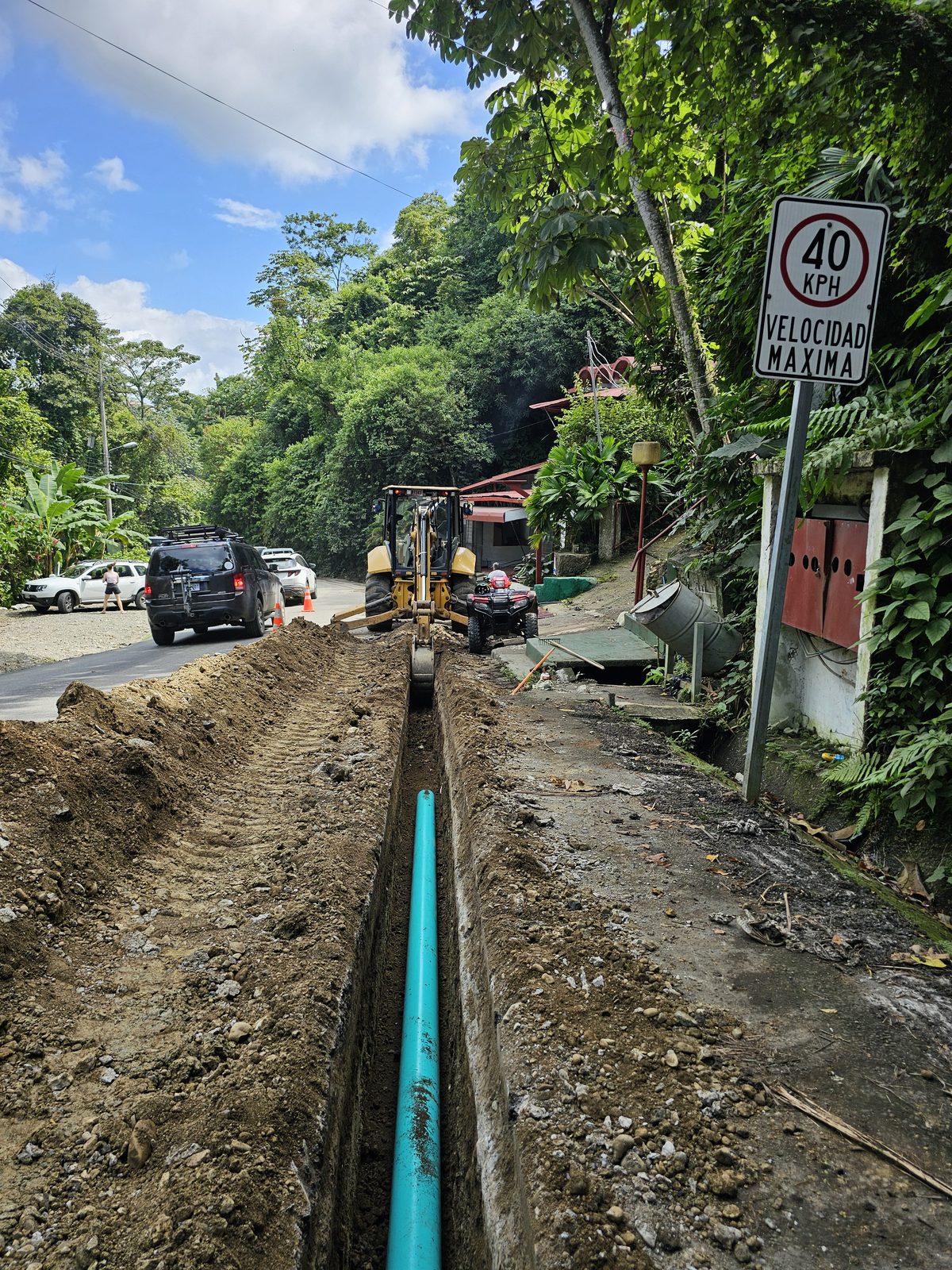

Pipeline construction works
02
The permitting

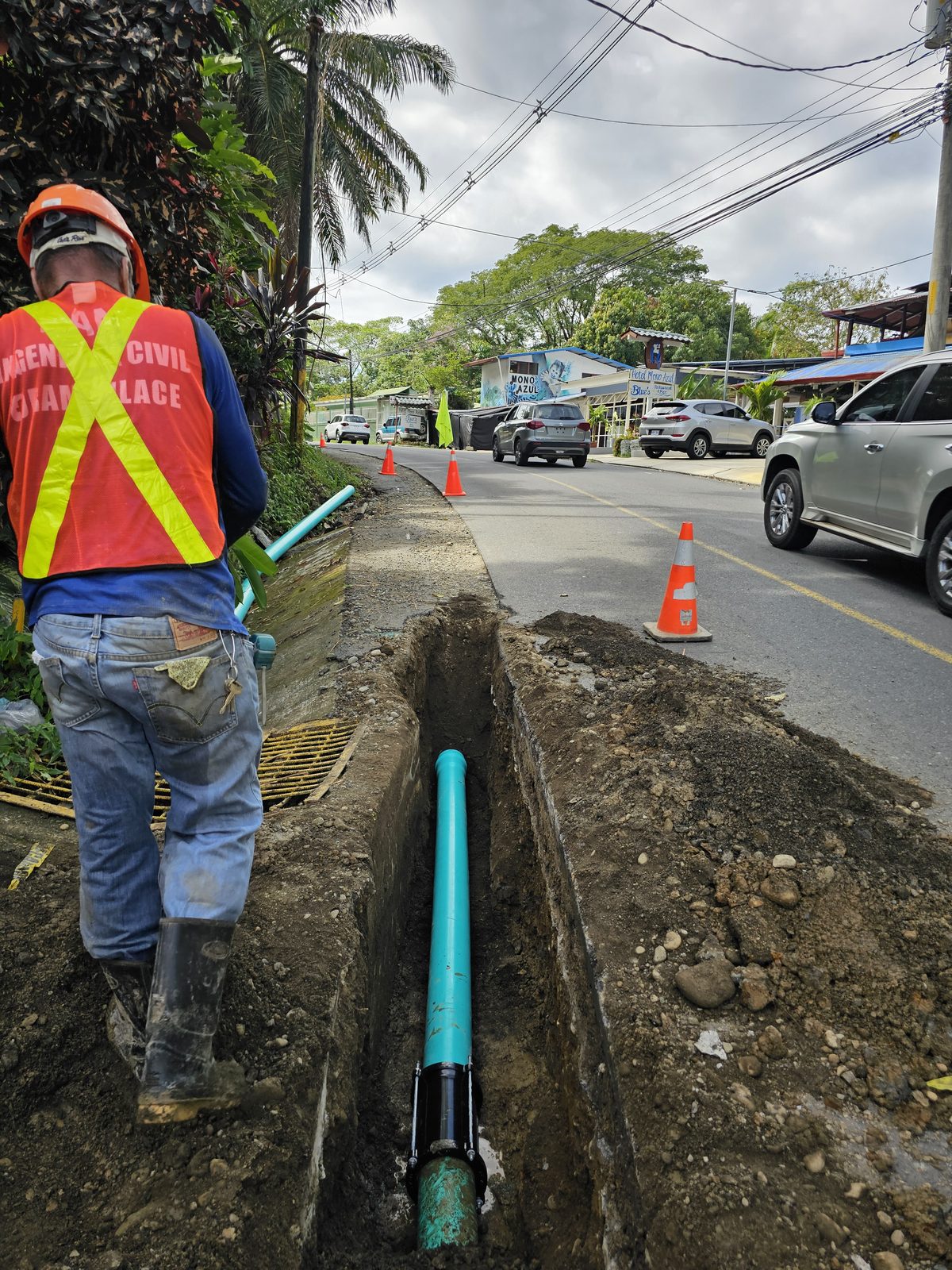

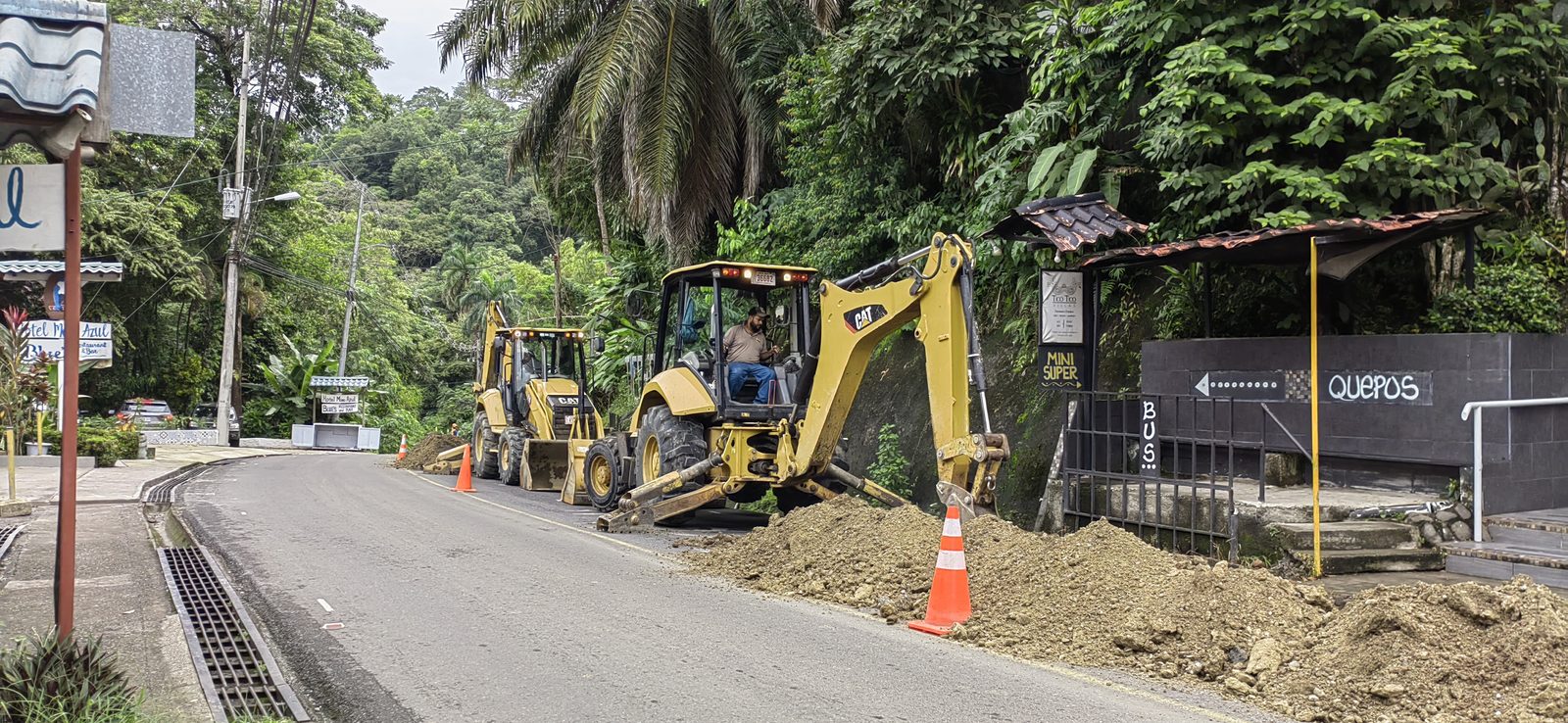

Permits, easement, and an injunction along the way

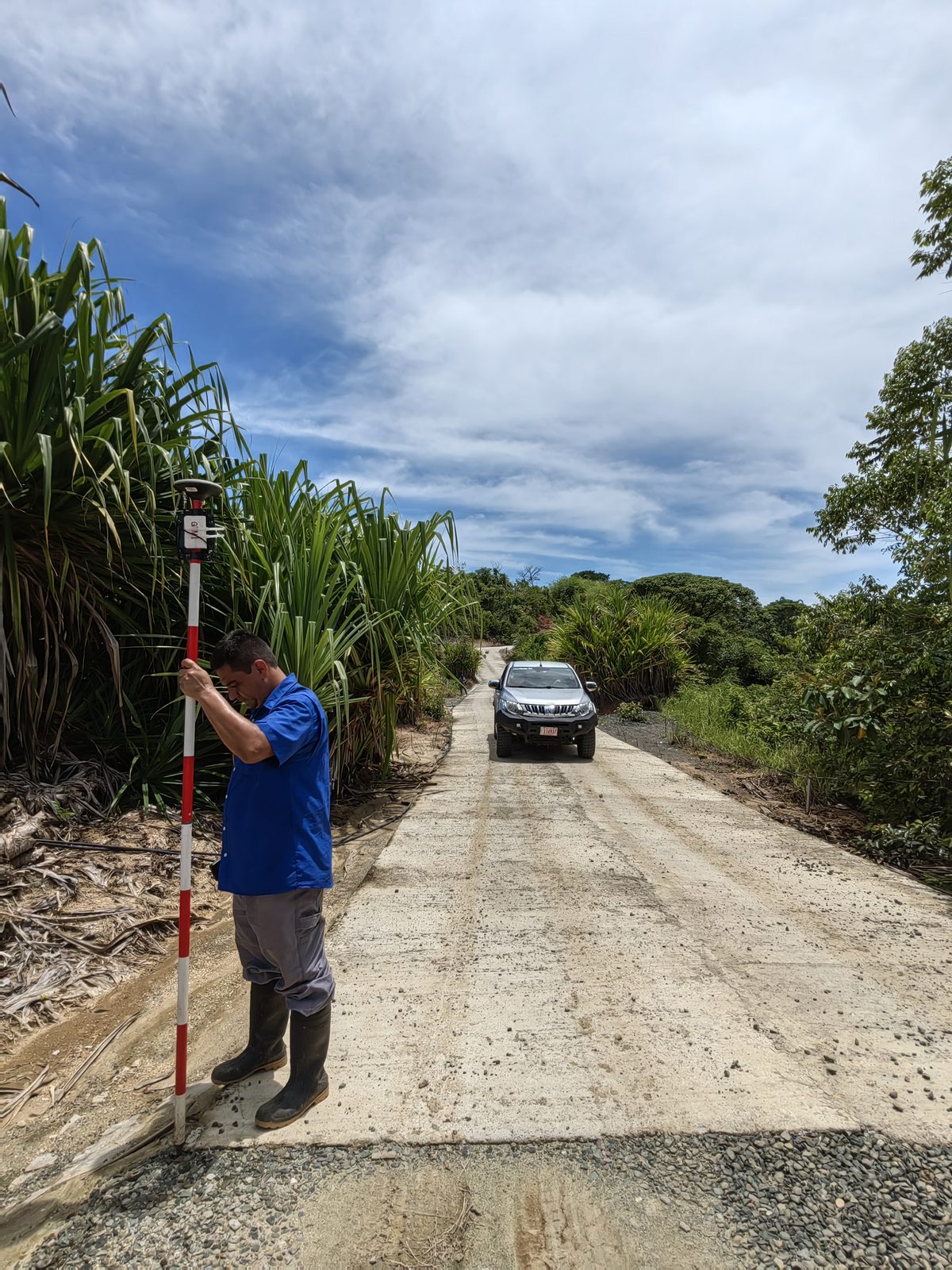

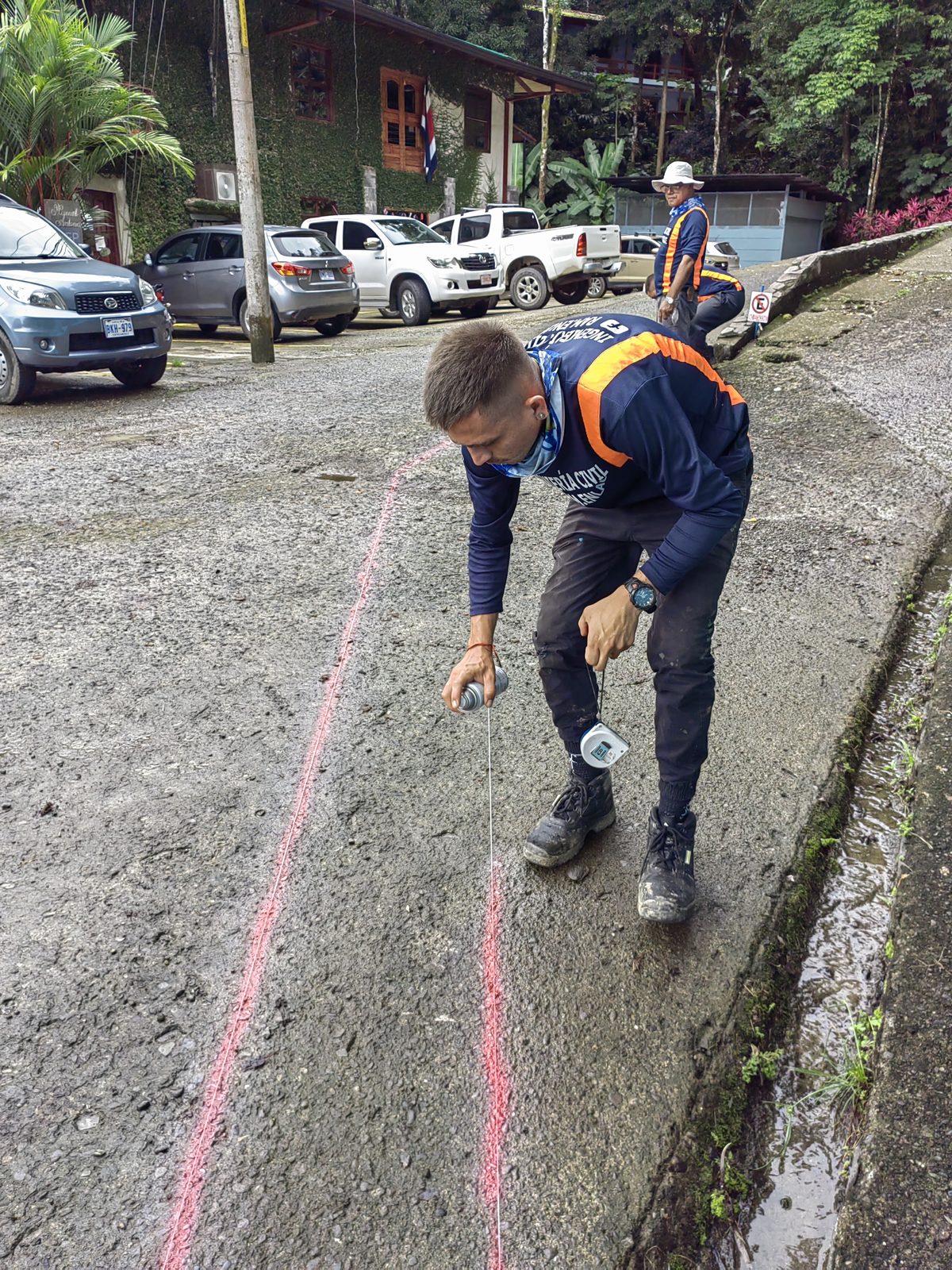

RAM took on the whole project: hydraulic assessment, design, plans, APC-CFIA (codes 1038731 and 1087685), the constitution and registration of the easement in favor of AyA, and the MOPT-CONAVI permits for the national road intervention.

When the file stalled, we used the legitimate tool that enforces deadlines: a constitutional injunction, filed and won. The project moved forward.

1constitutional injunction won

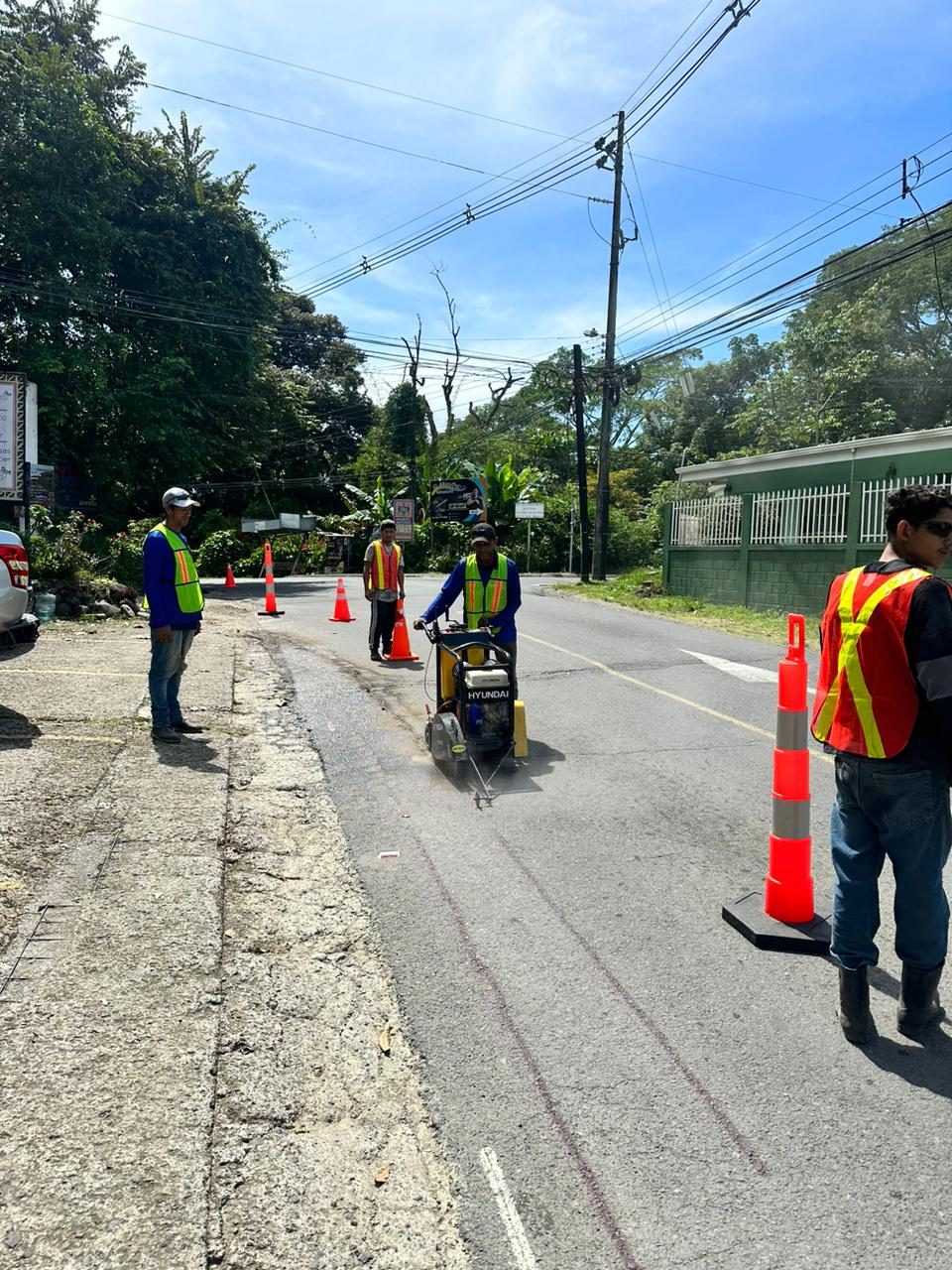

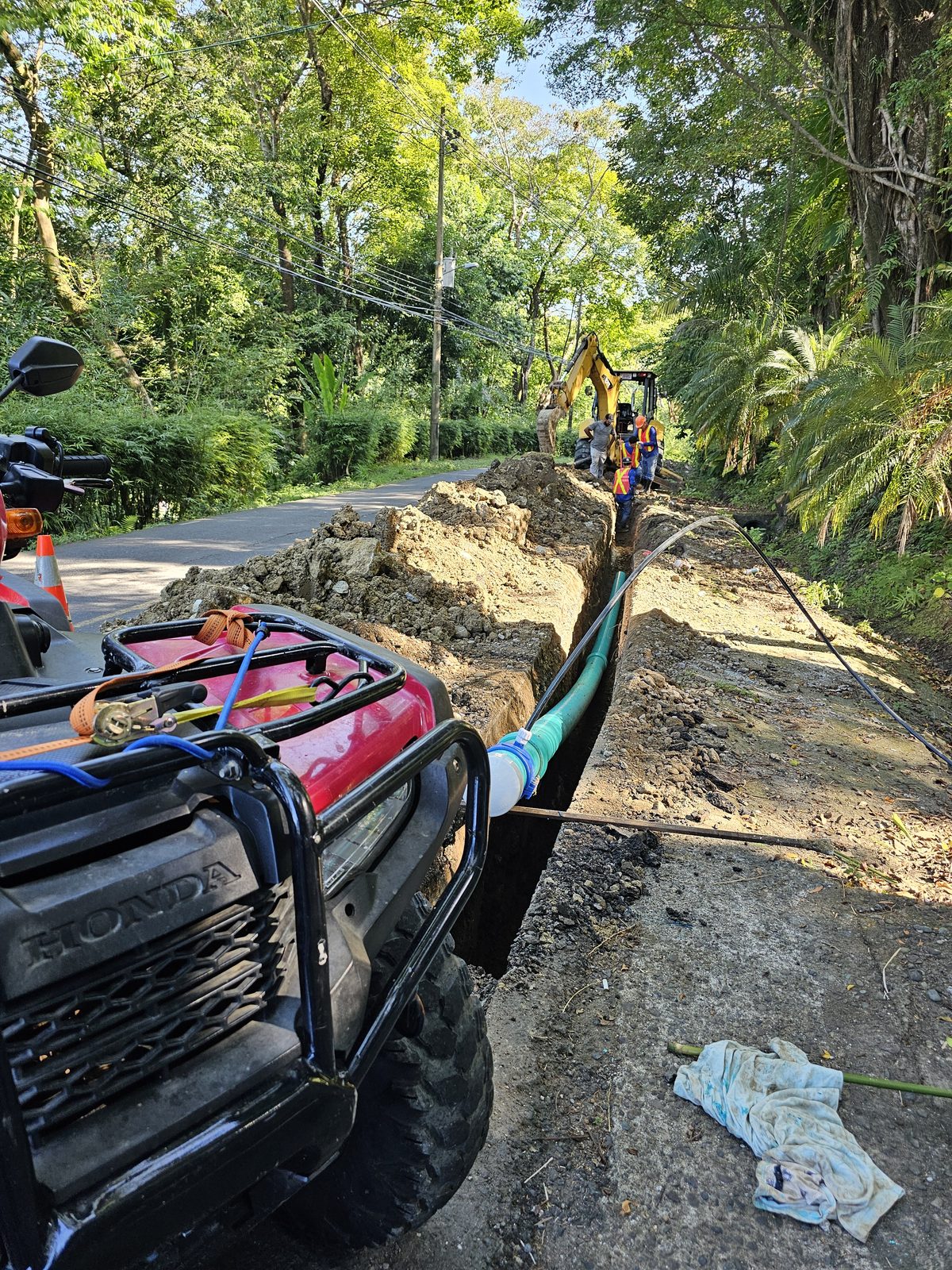

Works progressing along the road
03
The construction

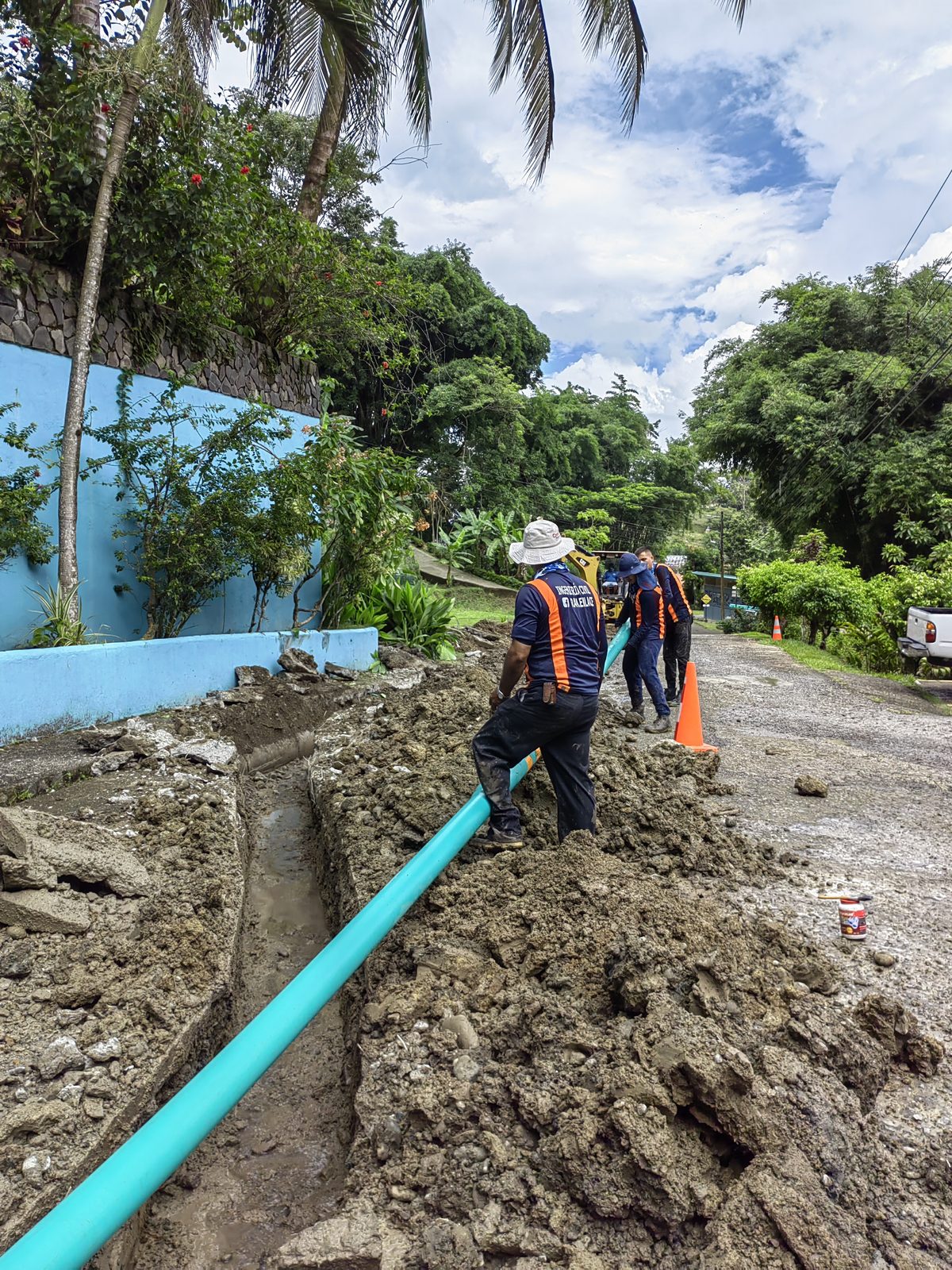

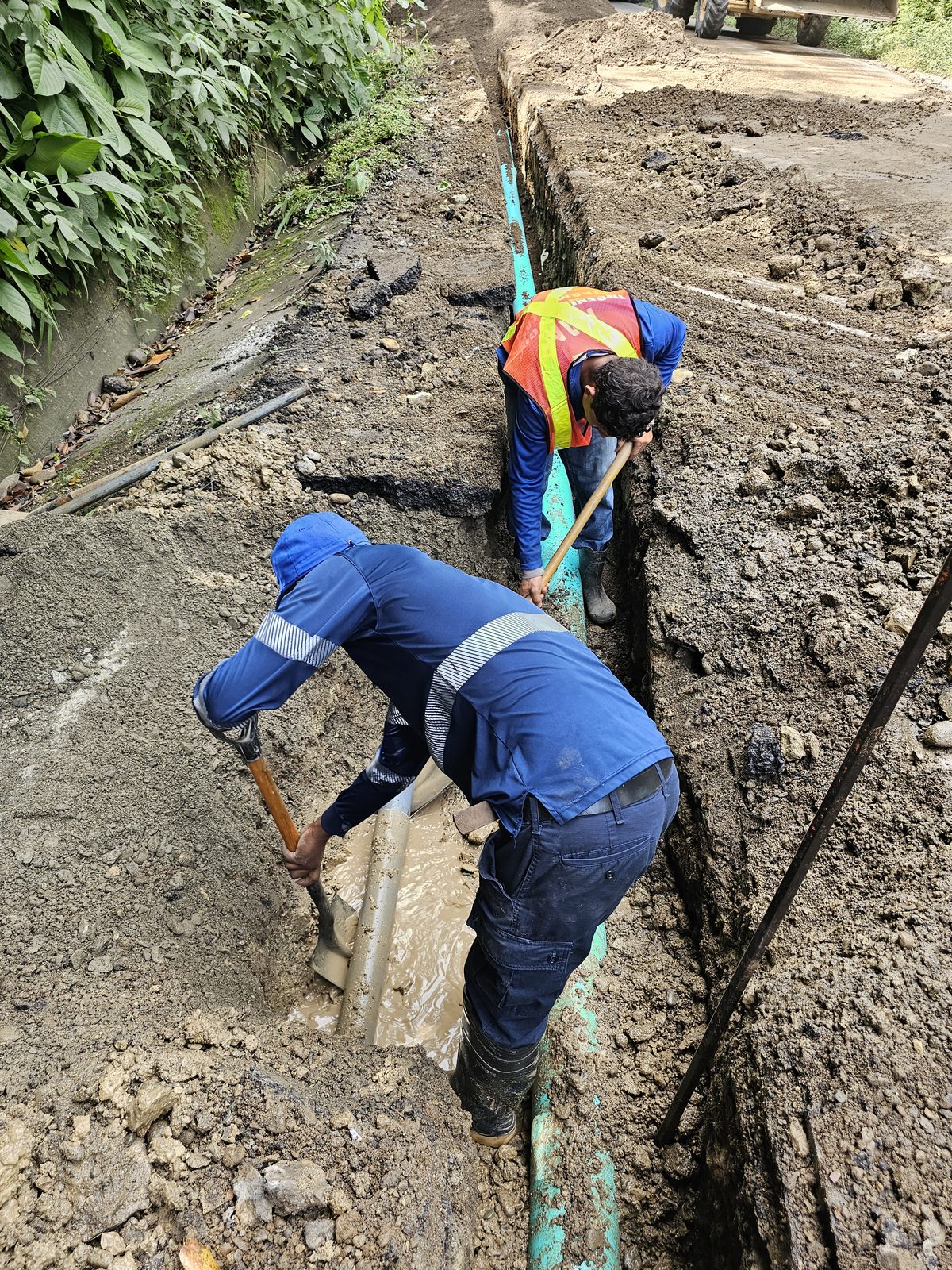

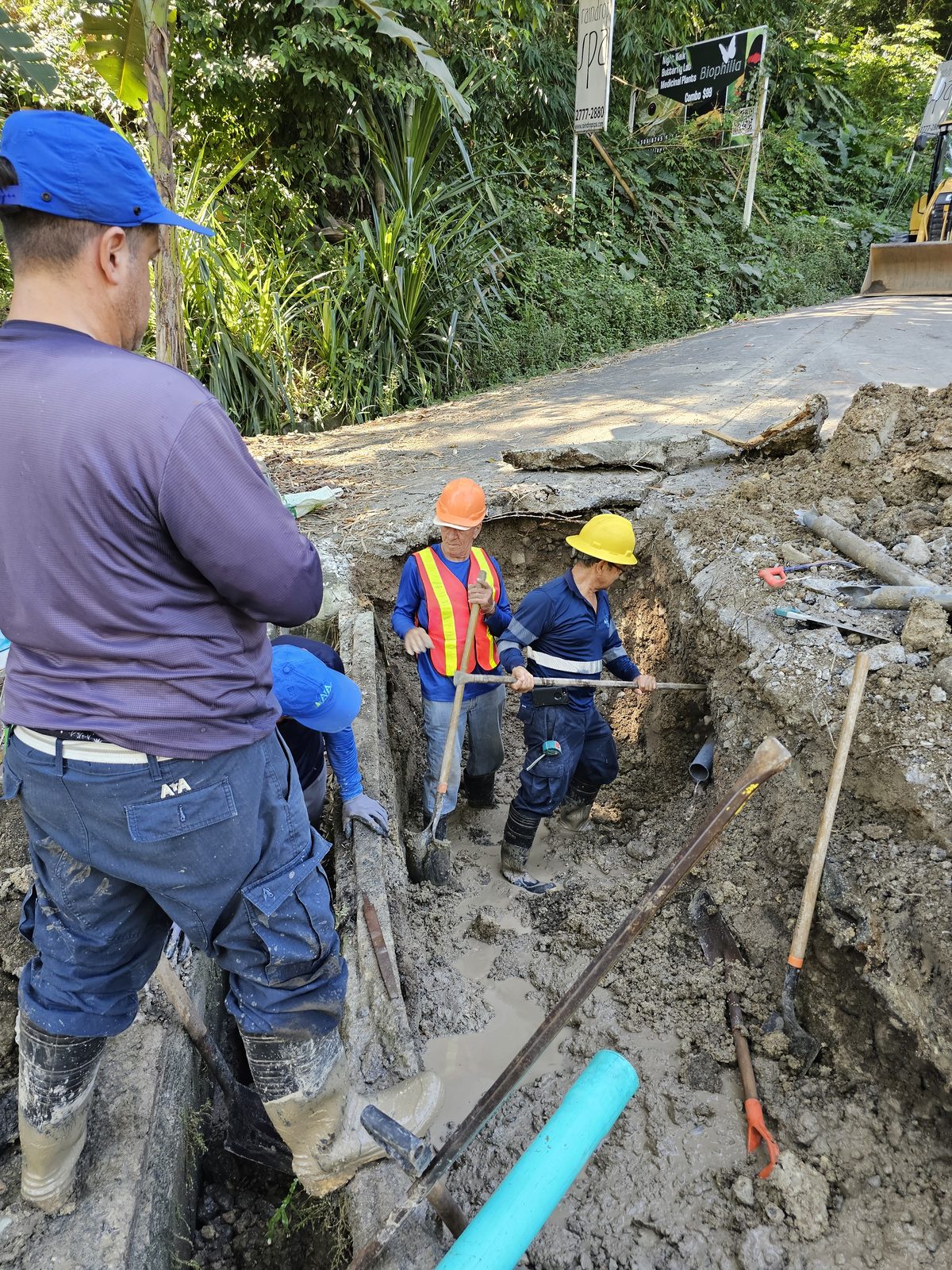

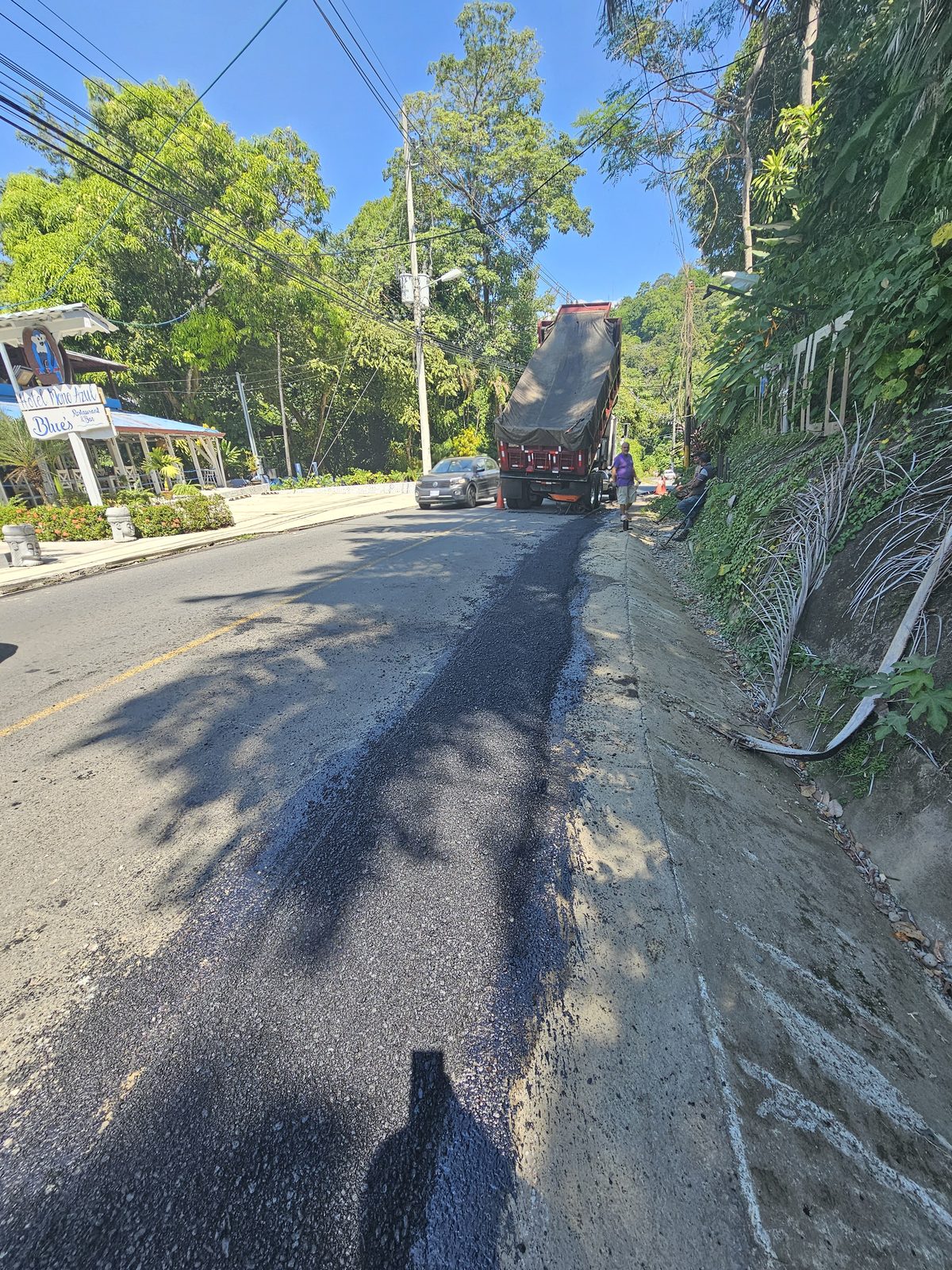

Three phases and a national road opened and restored

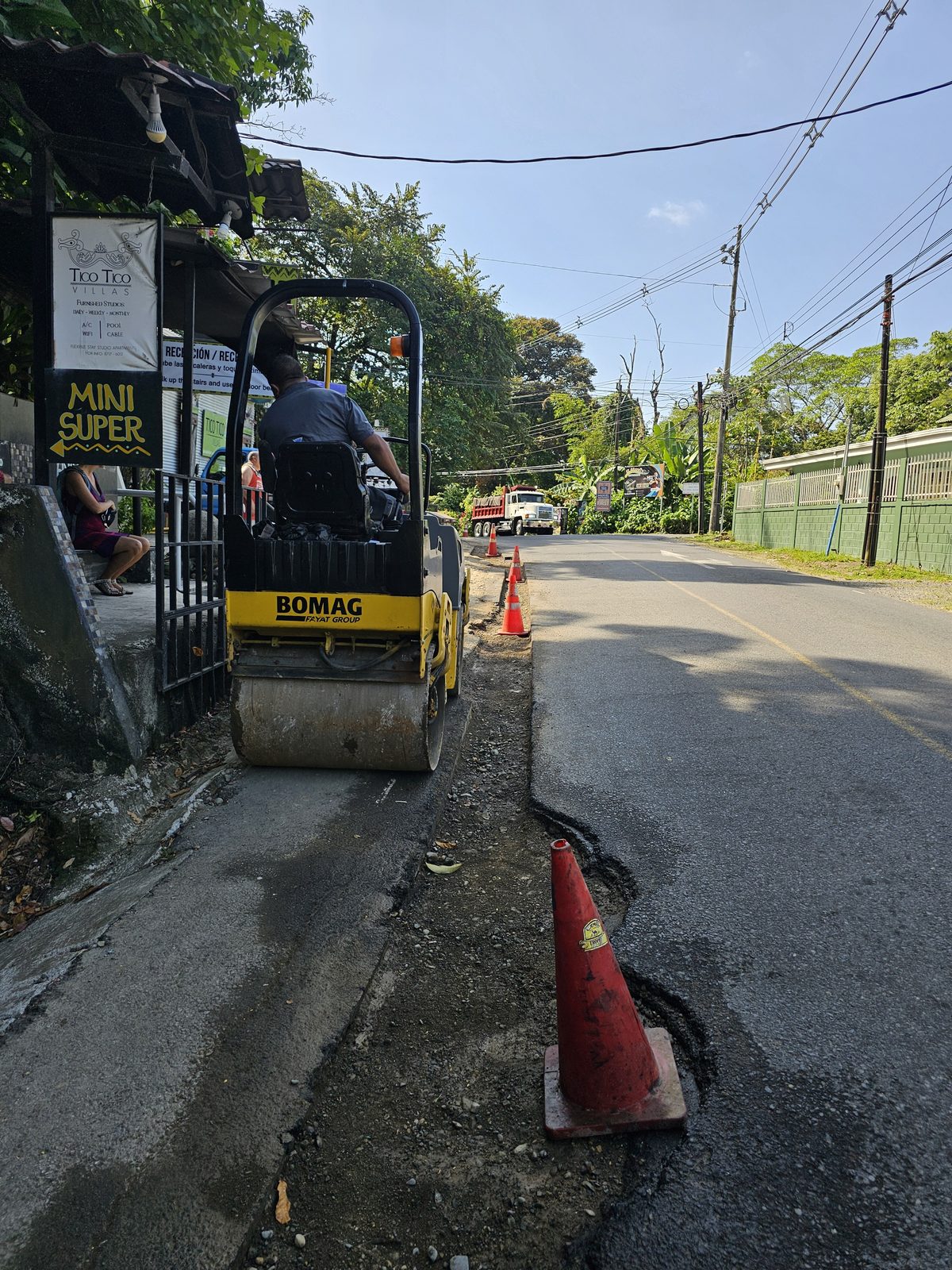

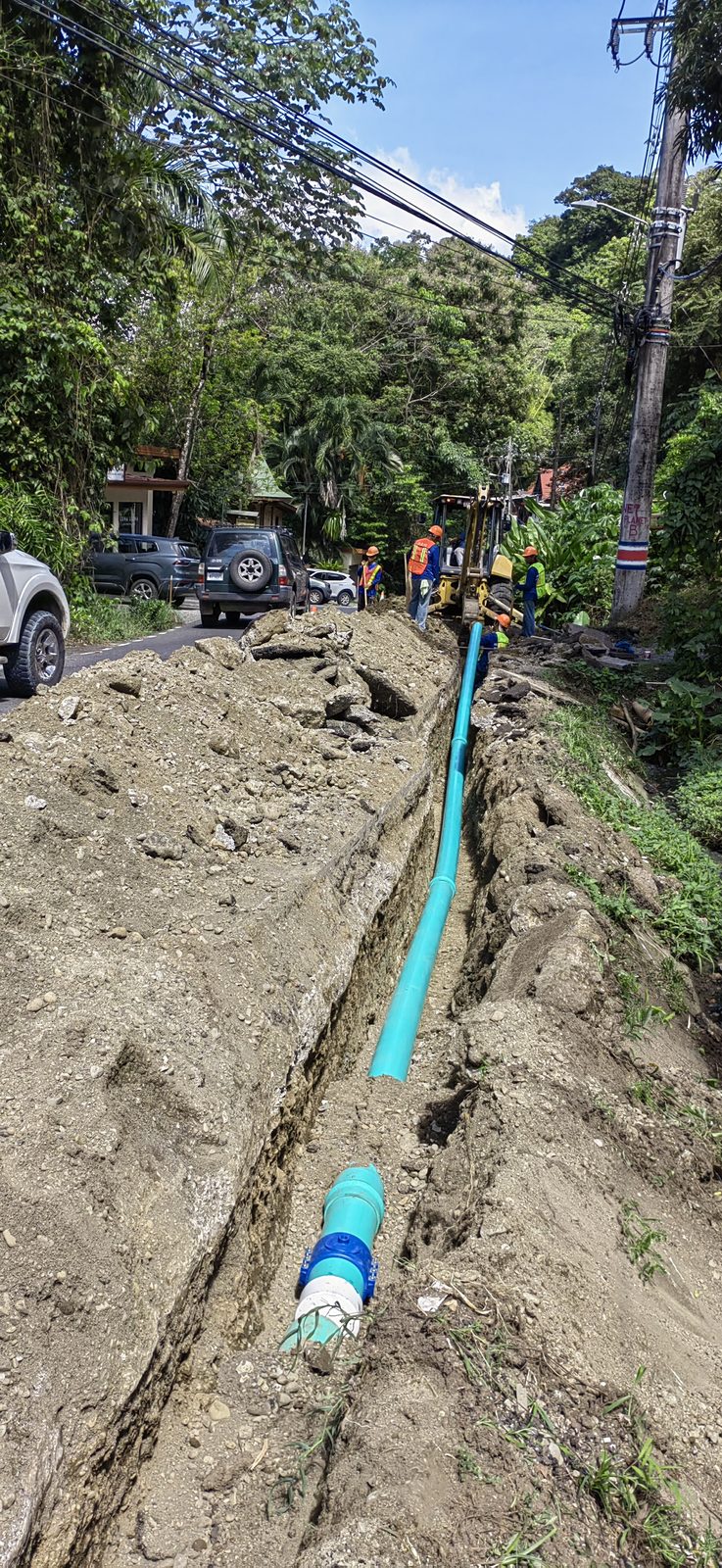

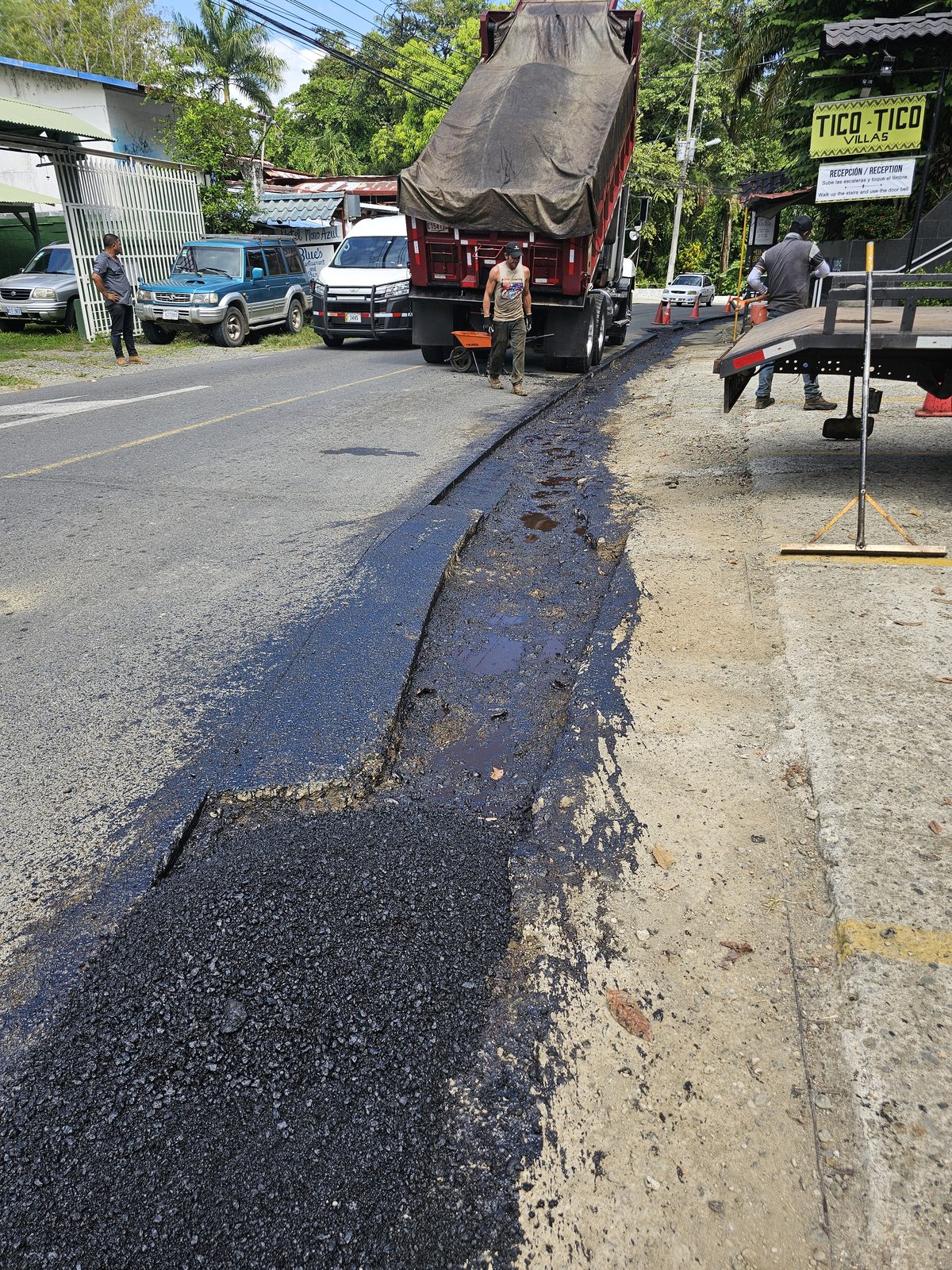

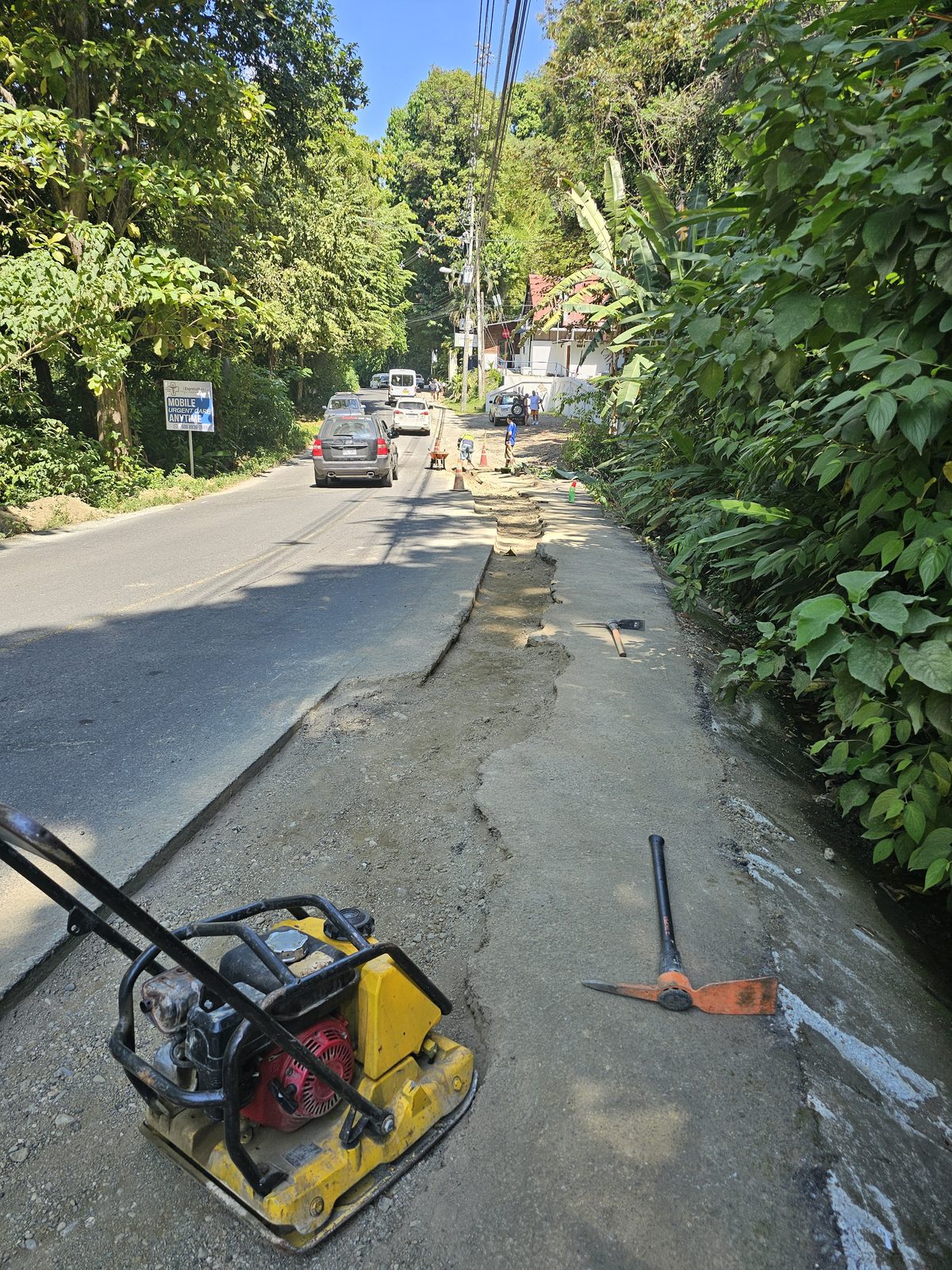

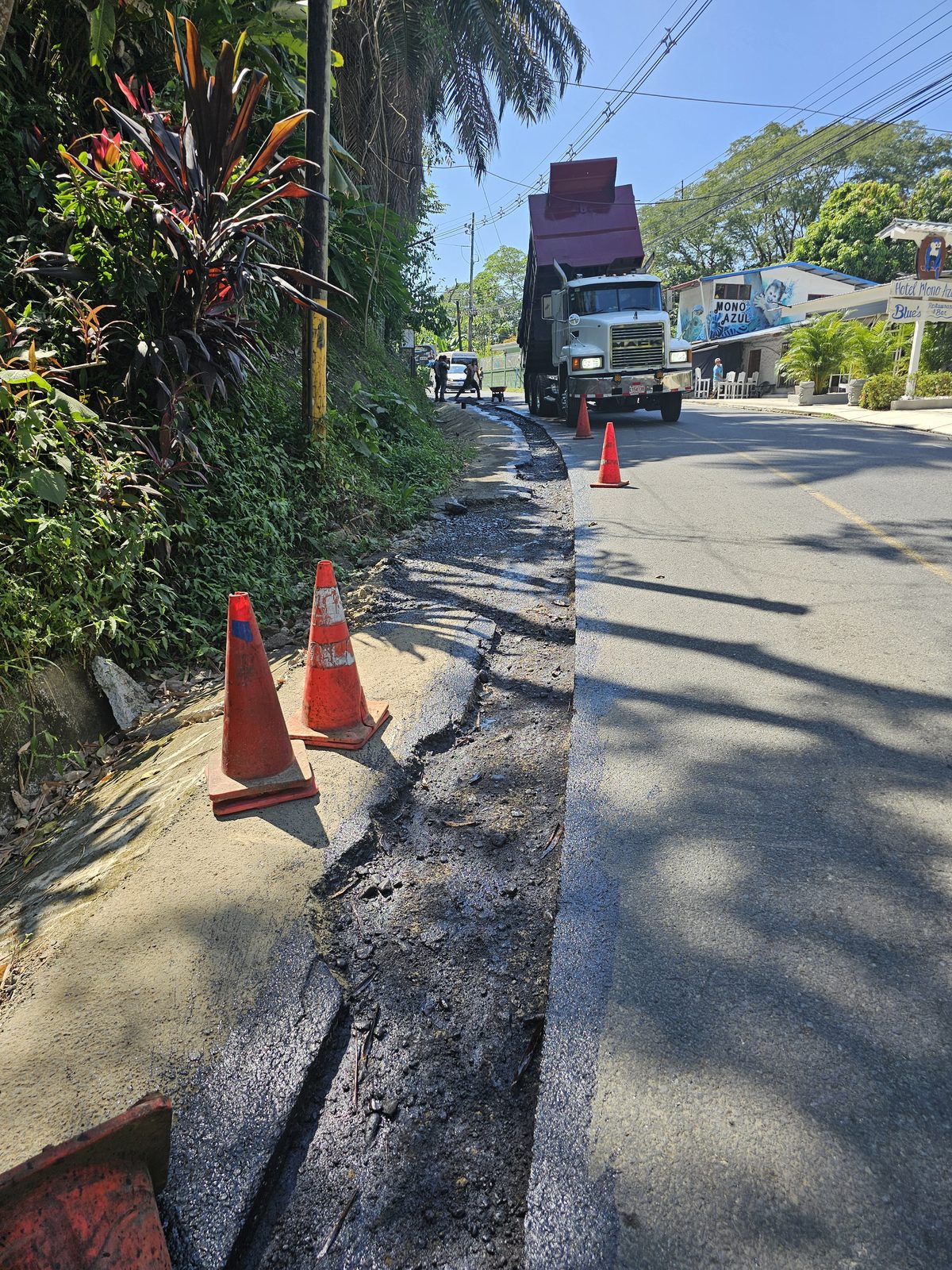

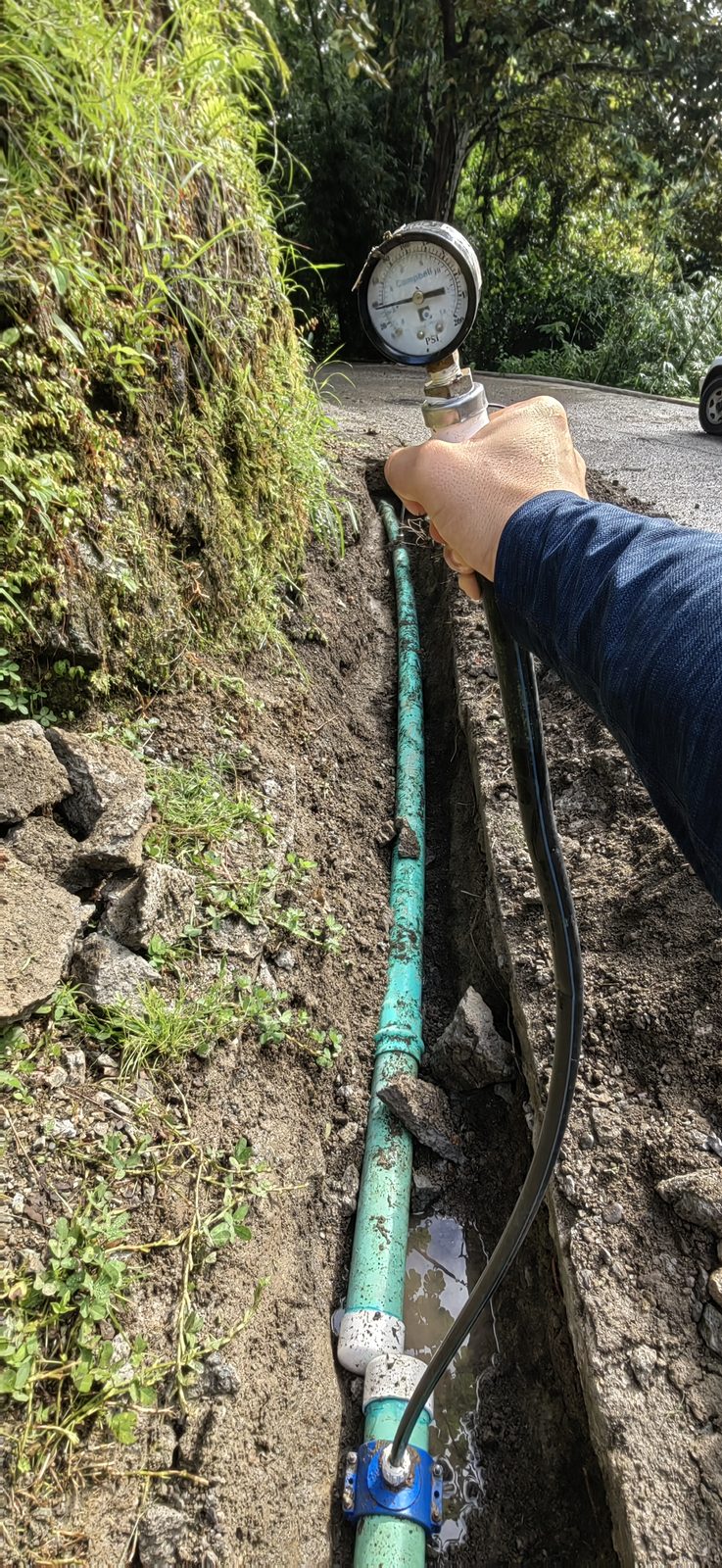

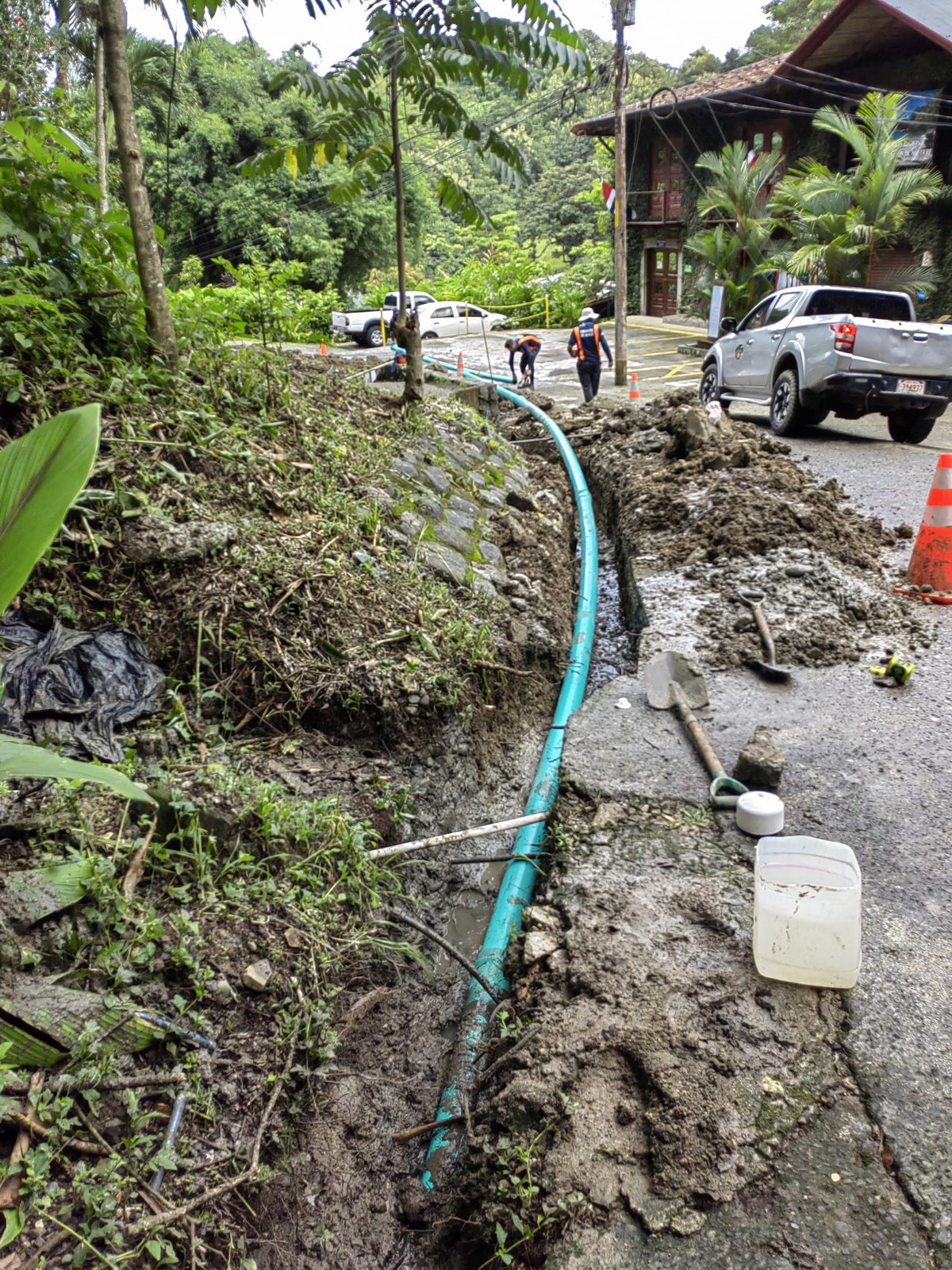

The works were executed in phases: 1,146 meters of 100 mm pipe and 1,096 meters of 150 mm, under RAM's technical direction, with certified materials and the national road cut and reinstatement under the MOPT/CONAVI protocol.

Every phase was photo-documented — the project archive exceeds 1,700 images — because that traceability is what sustains a reception without observations.

₡85.8 MCFIA valuation of the works
Finished Big Door Prize pipeline
04
The outcome

Received by AyA — and a client who came back twice

The extension was interconnected and formally received by AyA, enabling the tourism development's potable water supply.

The best metric isn't in the case file: the same client entrusted RAM with two more projects, Palmas Pacífica and Rickdonna. When an international developer repeats three times, the work spoke for itself.

100%received by AyA

The flagship that opened the way

National road, easement, injunction, and 2,242 meters of pipe received by AyA. If your project faces obstacles that seem impossible to align, this case proves it can be done — with method.

2,242 mof pipeline built and received
₡85.8 MCFIA valuation
3projects from the same client
1injunction won along the way
Request assessmentAsk on WhatsApp

Construction gallery

Technical data

Tubería2.242 m PVC 100/150 mm
Códigos CFIA1038731 / 1087685
Tasación₡85.792.857
PermisosRotura de vía nacional MOPT/CONAVI
ServidumbreConstituida a favor de AyA
UbicaciónQuepos, Puntarenas
